Project Details
Plant Design, Procurement and Construction of 2.6 MW Machi Hydropower project District Mardan (EPC Contract)
Hydropower Engineering
JV Partner (JV-partner)
Project Overview
TOTAL PROJECT COST
Rs. 1050.65 Million
TIMELINE / DURATION
7.0 Years (Apr-2017 to Dec-2017)
EMPLOYER / CLIENT
PakhtunKhwa Energy Development Organization (PEDO)
PEDO Hayatabad Peshewar, Pakistan
CONTRACTOR ROLE
Joint Venture Partner (JV-partner)
Technical Execution Scope & Summary
The Plant Design, Procurement, and Construction of the 2.6 MW Machi Hydropower Project in District Mardan were carried out under an EPC (Engineering, Procurement, and Construction) Contract. The project initiation took place in April 2017, and it successfully reached completion i...
Note: Detailed execution blueprints, drawings, and monthly reports are archived in the main corporate database.
Official Documentation & Certificates

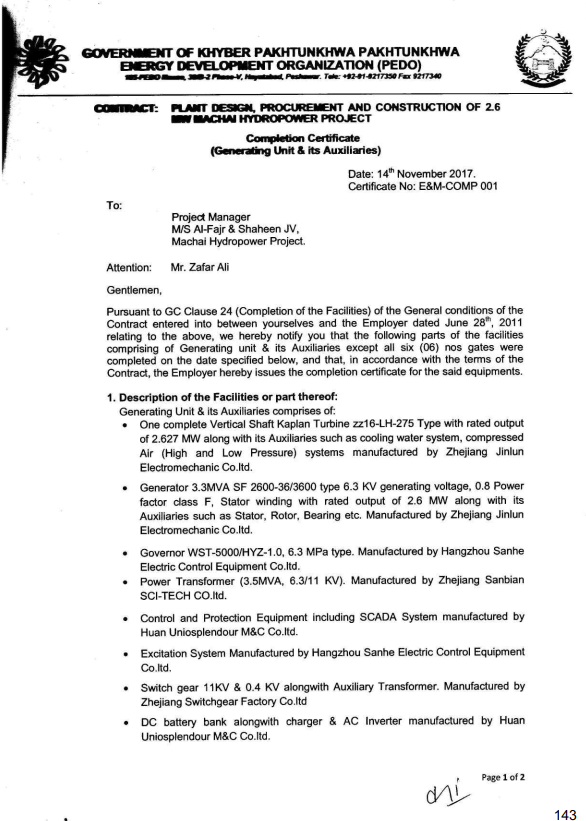

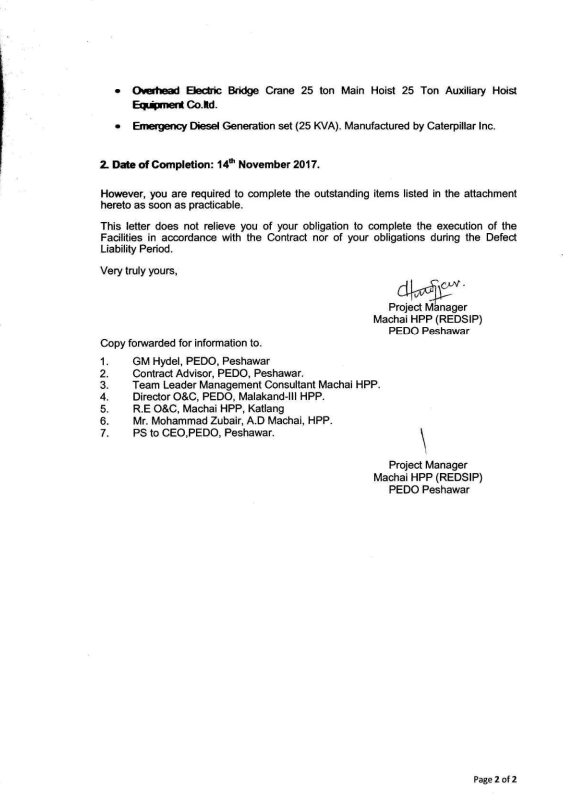

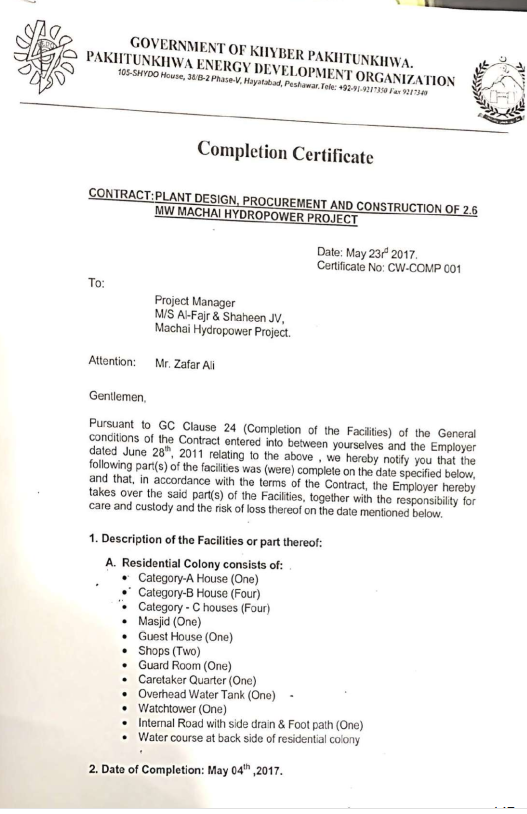

Machi HPP Attachment 1

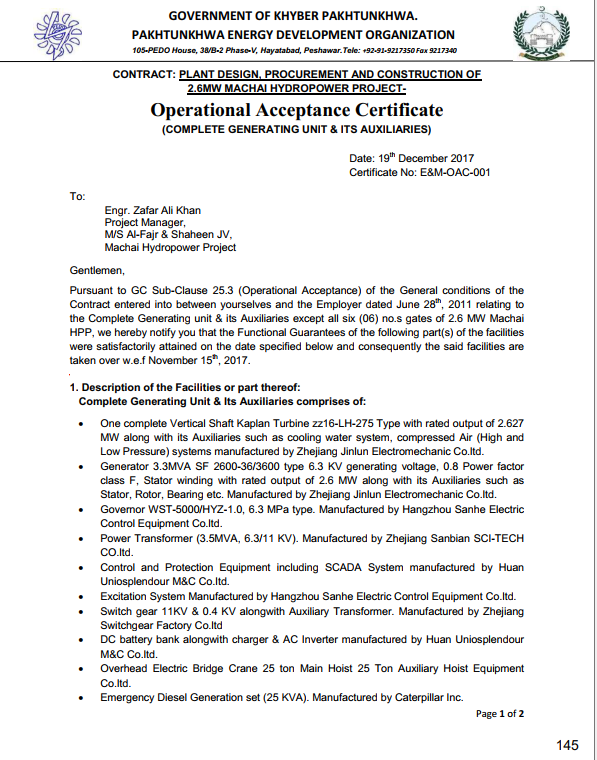

Machi HPP Attachment 2

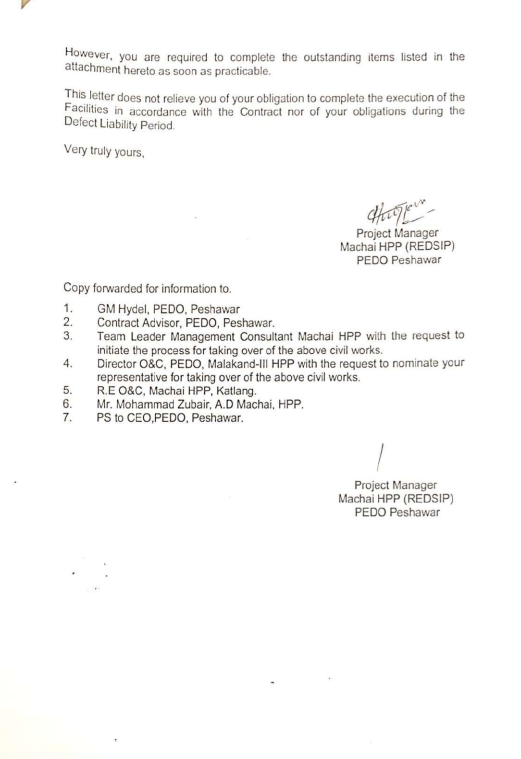

Machi HPP Attachment 3
Machi HPP Attachment 4

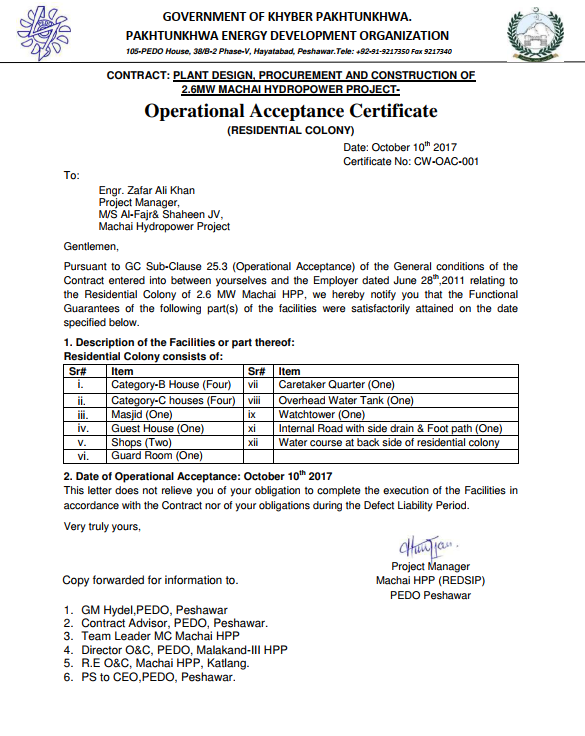

Machi HPP Attachment 5
Machi HPP Attachment 6

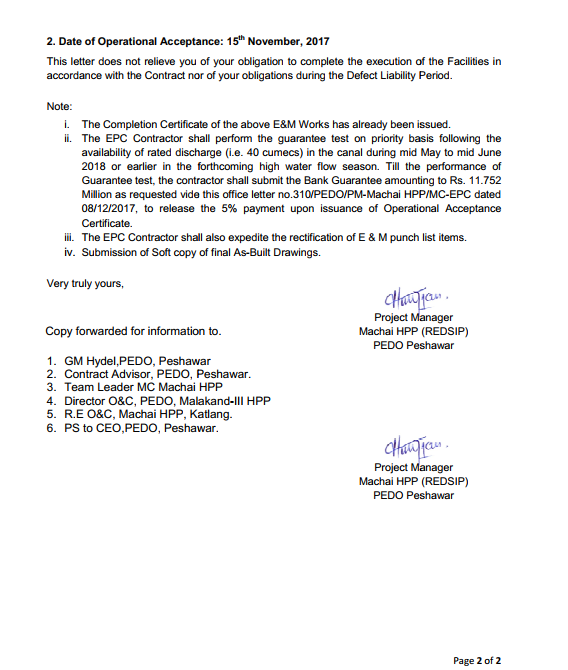

Machi HPP Attachment 7
Machi HPP Attachment 8
Machi HPP Attachment 9
Machi HPP Attachment 10
Machi HPP Attachment 11
Recommended Projects
Solo
Solo
Solo
Solo
